Neighbourhood and Alley Renewal construction is underway in Meyokumin.

Construction Update - August 2026

It’s the third year of Meyokumin Neighbourhood and Alley Renewal construction is underway. Work will consist of reconstruction and paving of the roads, removal and replacement of public sidewalk, curb, gutter and street lighting.

Work is ongoing in the following locations:

  • Catchbasin replacements and relocations on 17A Avenue from 54 Street to 51 Street, and 53 Street from 17A Avenue to 17 Avenue
  • Pouring concrete sidewalk and driveway on the north side of 22 Avenue from 57 Street to 52 Street, the east side of 52 Street from 22 Avenue to 19 Avenue, the west side of 19A Avenue from 56 Street to 55 Street, the west side of 54 Street from 19 Avenue to 18 Avenue and the south side of 19 Avenue from 54 Street to 50 Street

Upcoming work is occurring in the following locations:

  • Road removal on 19A Avenue from 61 Street to 56 Street and the east side of 54 Street from 19A Avenue to 18A Avenue
  • Milling and paving the parking lot at the Corner Store complex, located at the intersection of 19A Avenue and 57 Street
  • Finishing Paving on 54 Street from 19A Avenue to 18A Avenue and 19 Avenue from 54 Street to 50 Street early August
  • Finishing road reconstruction and concrete work in front of the school (19A Avenue and 57 Street)
  • Removals on 62 Street and 19A Avenue roadway will start once work in front of the school is complete
  • Continuing construction of the new shared-use path along 54 Street inside from 18 Avenue to Mill Woods Road
  • Continue removals along the outside of 18A Avenue and 51 Street. Concrete placement is set to begin early to mid-August.
  • Potential to continue with removals along outsides of 54 Street shared-use path from 18 Avenue to Mill Woods Road
  • Potential to start roadway foaming in 52 Street and 22 Avenue area in late August
  • CCC / deficiency work is ongoing

Open Spaces Construction

As part of Neighbourhood Renewal, construction is happening in some of Meyokumin’s open spaces. In August, crews will:

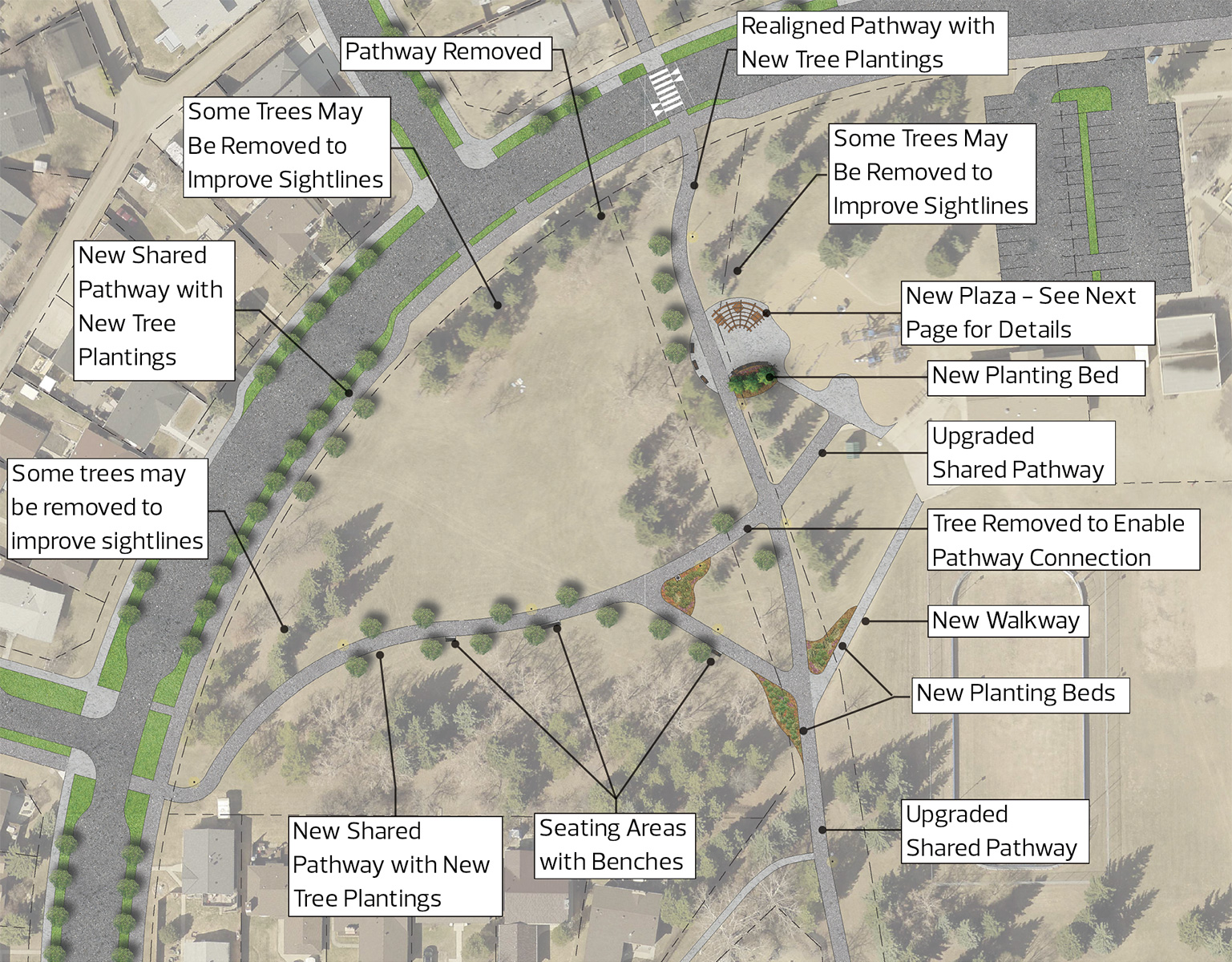

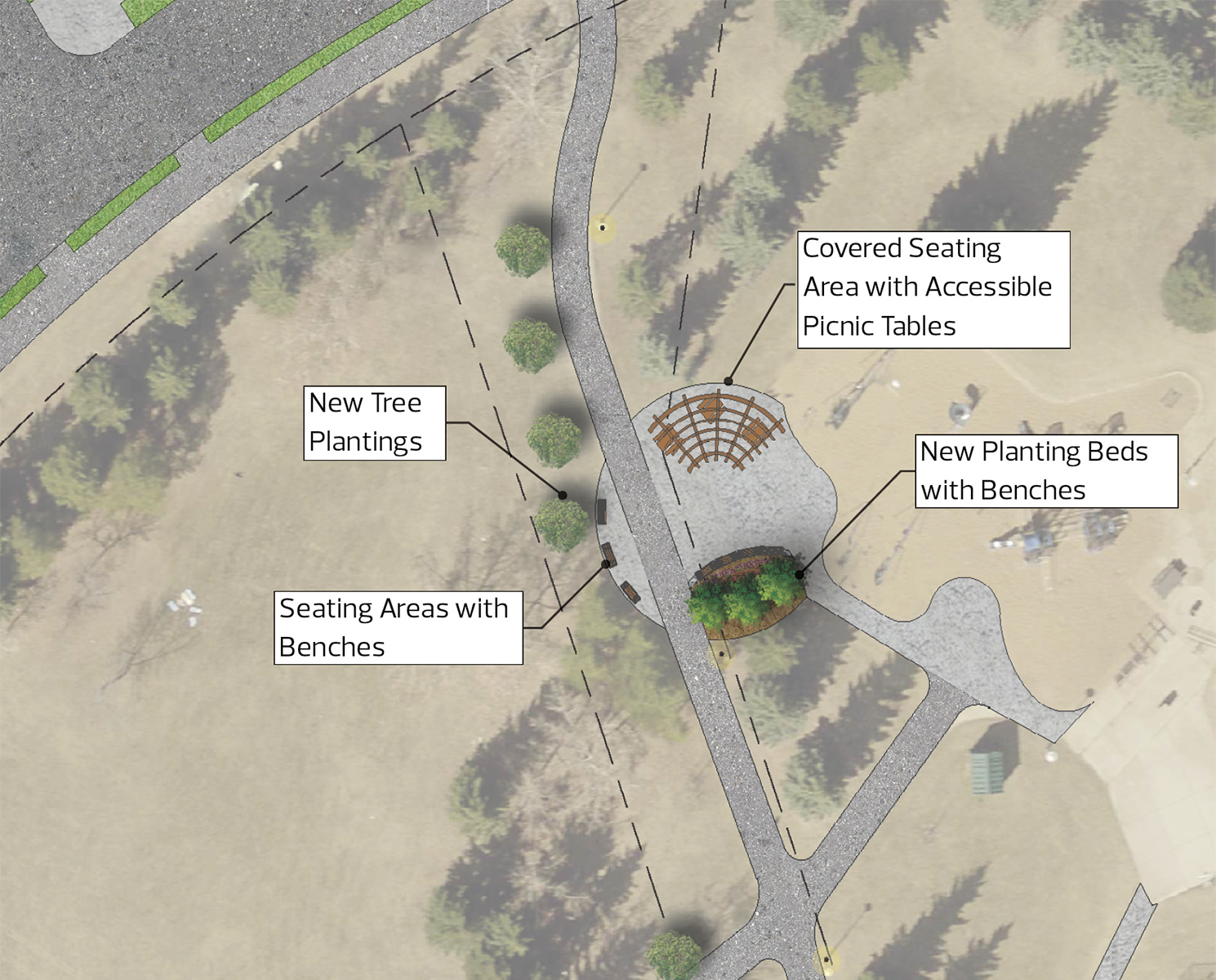

  • Finish the tie-in trail on the northwest side of Meyokumin Park
  • Build a planting bed south of Meyokumin Elementary School to mitigate flooding
  • Start landscaping work along 62 Street NW

Progression of Work

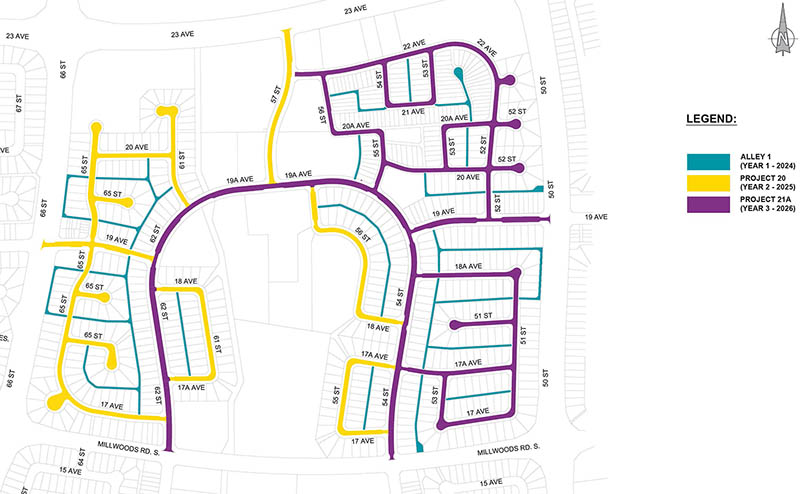

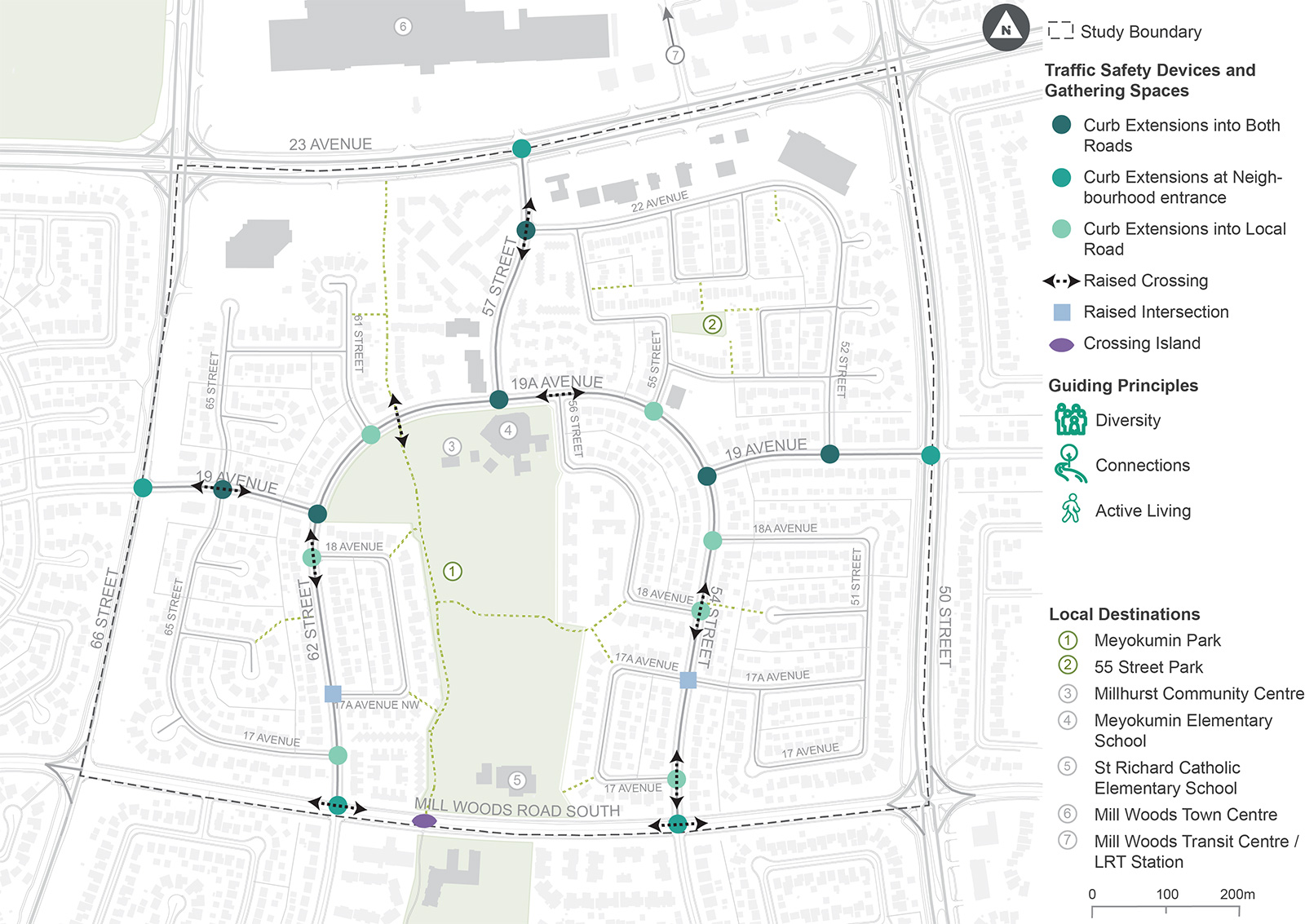

The contractor working for the City has developed a map to show the progression of work, including scheduled closures.

See Contractor Map

Check out the links below to prepare for construction:

The City of Edmonton and EPCOR are working together to construct Low Impact Development, which will help with stormwater retention and help mitigate flooding.

If you live in the 2026 construction area, please watch your mailbox for construction bulletins that will provide more information along with details on landscaping and access. All residents and business owners are asked to access their homes and businesses through the back entrances and alleys, where possible, during construction. If no alley access is available and/or you have special access requirements (such as DATS or a temporary access ramp  to the front of your home), please contact the Construction Project Manager, David Ha, 780-496-4055, to coordinate.

Construction in Meyokumin began in spring 2024 and is expected to take 3 years (planned completion late fall 2026). Neighbourhood renewal in Meyokumin is progressing on time and on budget.
