Capital Line Design-Build Ltd., a member of the Ledcor Group of Companies, with AECOM as their design partner, has been awarded the Design-Build contract for Phase 1 of the Capital Line South Extension project.
Ledcor began major construction in 2025, with anticipated completion in 2029, followed by testing and commissioning.
Project Update - November 2026
111 Street Near Blackmud Creek
- Throughout 2026, residents will experience significant construction-related impacts, particularly along 111 Street near the Blackmud Creek Bridge.

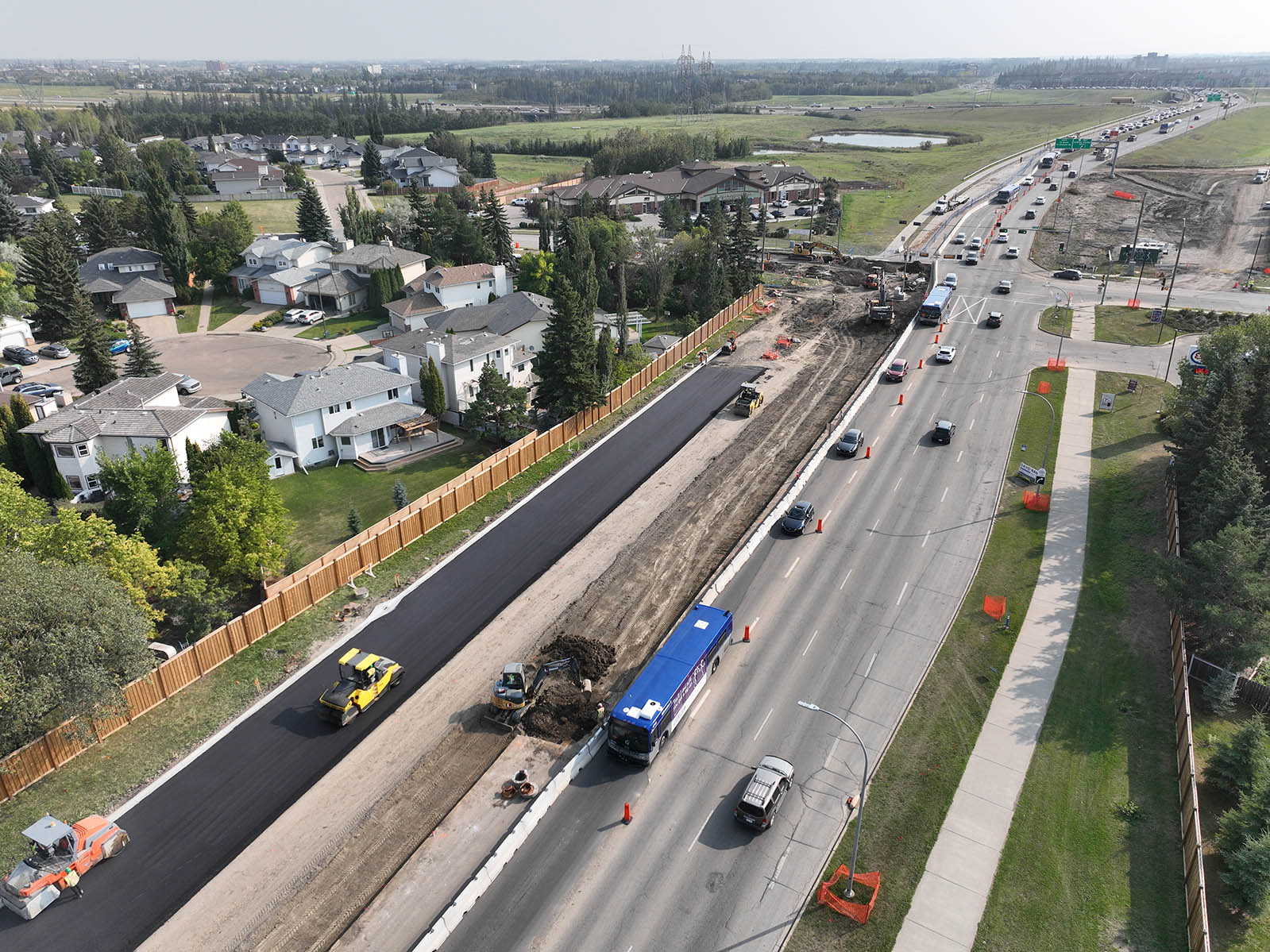

- Ledcor, the contractor for the Capital Line South LRT Extension, will continue critical work and paving through the end of the 2026 construction season. The goal is to restore sections of 111 Street to two lanes in each direction before the end of the year.
For more information:
Construction Notices
November 5, 2026: 9 Avenue Partial Reopening
October 30, 2026: 9 Avenue West Partial Reopening
October 20, 2026: Permanent Access Change at 25 Avenue Near Century Park Station
October 14, 2026: 9 Avenue West Progress and Reopening Timeline
October 6, 2026: Southbound lane closure near Century Park Station
August 13, 2026: Full Closure of 9 Avenue West
July 16, 2026: 12 Avenue West Progress and Upcoming 9 Avenue West Closure
July 16, 2026: Full Closure of Saddleback Road West and 19 Avenue Lane Closures
May 22, 2026: Reminder about Full Closure of 12 Avenue West
May 6, 2026: Off-Peak Northbound Lane Closure on 111 Street near Anthony Henday Drive
April 24, 2026: Full Closure of 12 Avenue West
March 30, 2026: Continued Lane Closures Along Blackmud Creek Bridge and New Lane Closure at 12 Avenue
February 5, 2026: Tree Removals in Blackmud Creek
January 22, 2026: Off-peak Lane Closures on 111 Street near YMCA and FreshCo

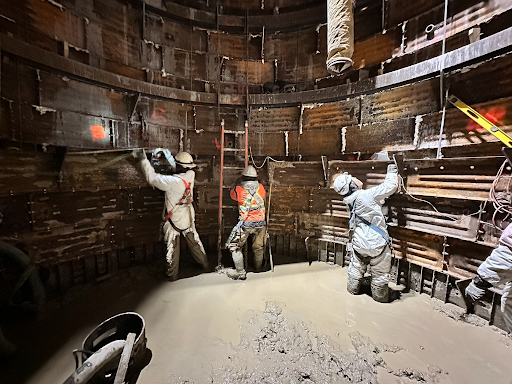

January 16, 2026: Piling near 12 Avenue for Twin Brooks Utility Complex
October 23, 2026: 110 Street Southbound Lane Closure at 23 Avenue

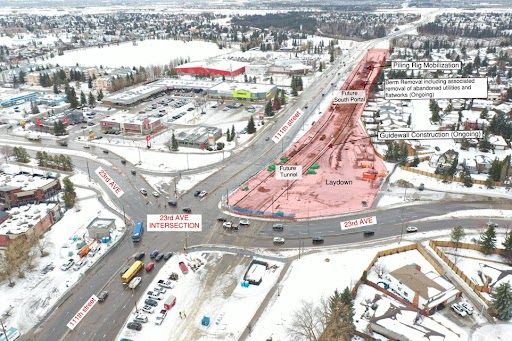

September 19, 2026: 111 Street and 23 Ave Intersection Reconfiguration
August 26, 2026: Westbound/Eastbound Lane Closures on 23 Avenue
June 4, 2026: 23 Avenue Reconstruction
May 26, 2026: Off-peak Westbound/Eastbound Lane Closure on 23 Avenue
May 12, 2026: Southbound Lane Closures on 111 Street near 23 Avenue
February 6, 2026: Overnight work near 111 Street and 23 Avenue
January 8, 2026 – EPCOR Utility Relocation near Blackmud Creek
October 21, 2026: Lane Reduction on 135 Street north of Ellerslie Road
June 18, 2026 - Construction Notice: Heritage Valley Transit Centre + Kiss & Ride Access Closures
June 12, 2026 - Construction Notice - ATCO Pipeline Lowering Along Ellerslie Road
January 16, 2026: Off-peak lane closures on Ellerslie Road and Heritage Valley Trail SW
June 9, 2026: Off-Peak Anthony Henday Drive Lane Closures for Bridge Girder and Arch Steel Delivery
June 2, 2026: Off-Peak Anthony Henday Drive Median Lane Closures
March 19, 2026: Piling work for Anthony Henday Drive LRT Bridge
Public Notice – Emergency Response Plan during upcoming 12 Avenue west intersection closure
Sign up for project updates
LRT Projects
Construction Progress (2026)
12 Avenue Intersection Shutdown Timelapse
2025 Construction Progress Summary
Blackmud Creek LRT Bridge Girders
Project Renderings (subject to change)
About The Project
The extension will be completed in two phases. Phase 1 will extend the line from Century Park to just north of Ellerslie Road, and Phase 2 will extend from Ellerslie Road to Allard/Desrochers. Concept design for Phase 2 has been advanced.
Capital Line South Phase 1 (Century Park to just north of Ellerslie Road) is a 4.5 km long, high-floor LRT and includes:

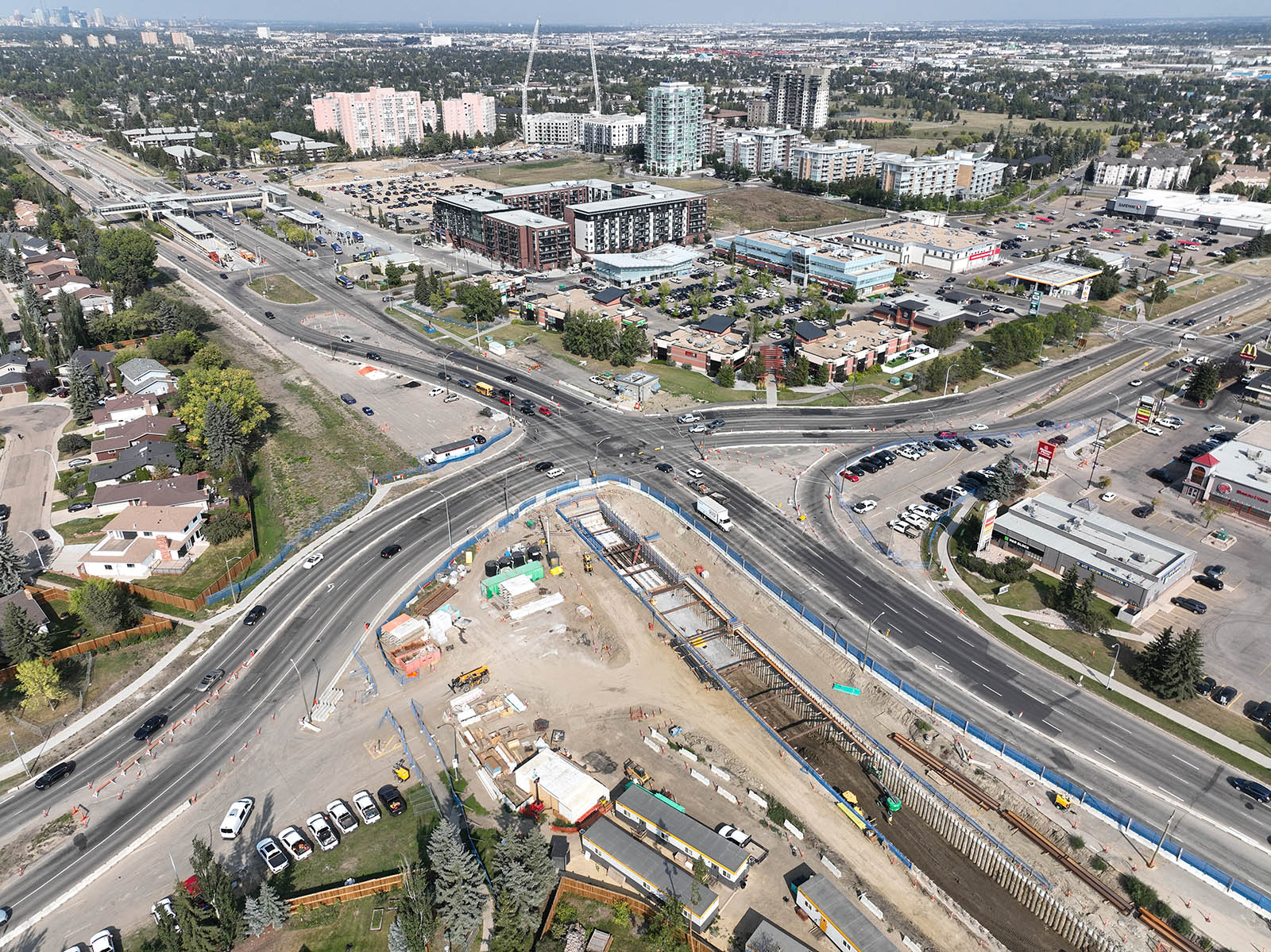

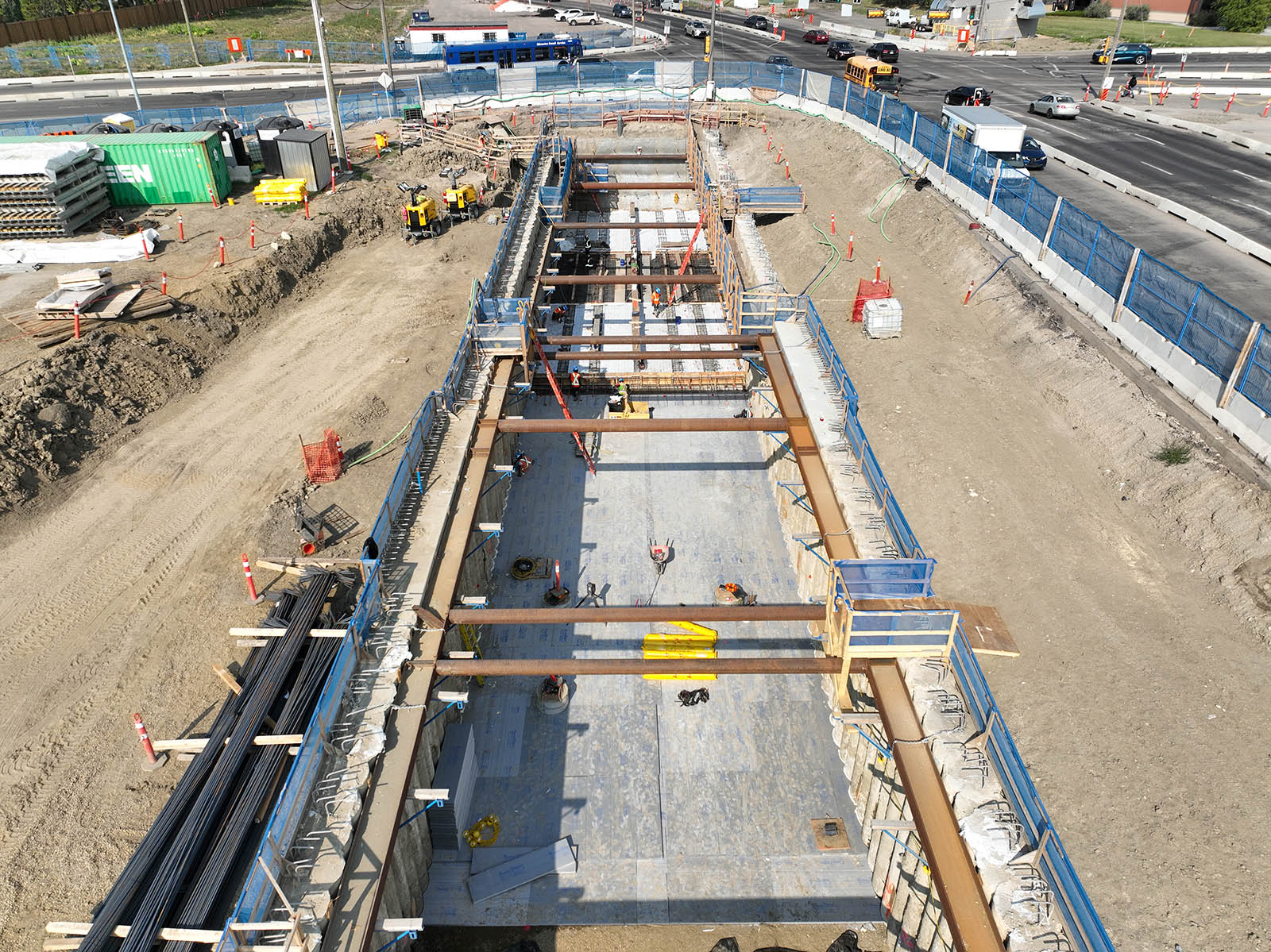

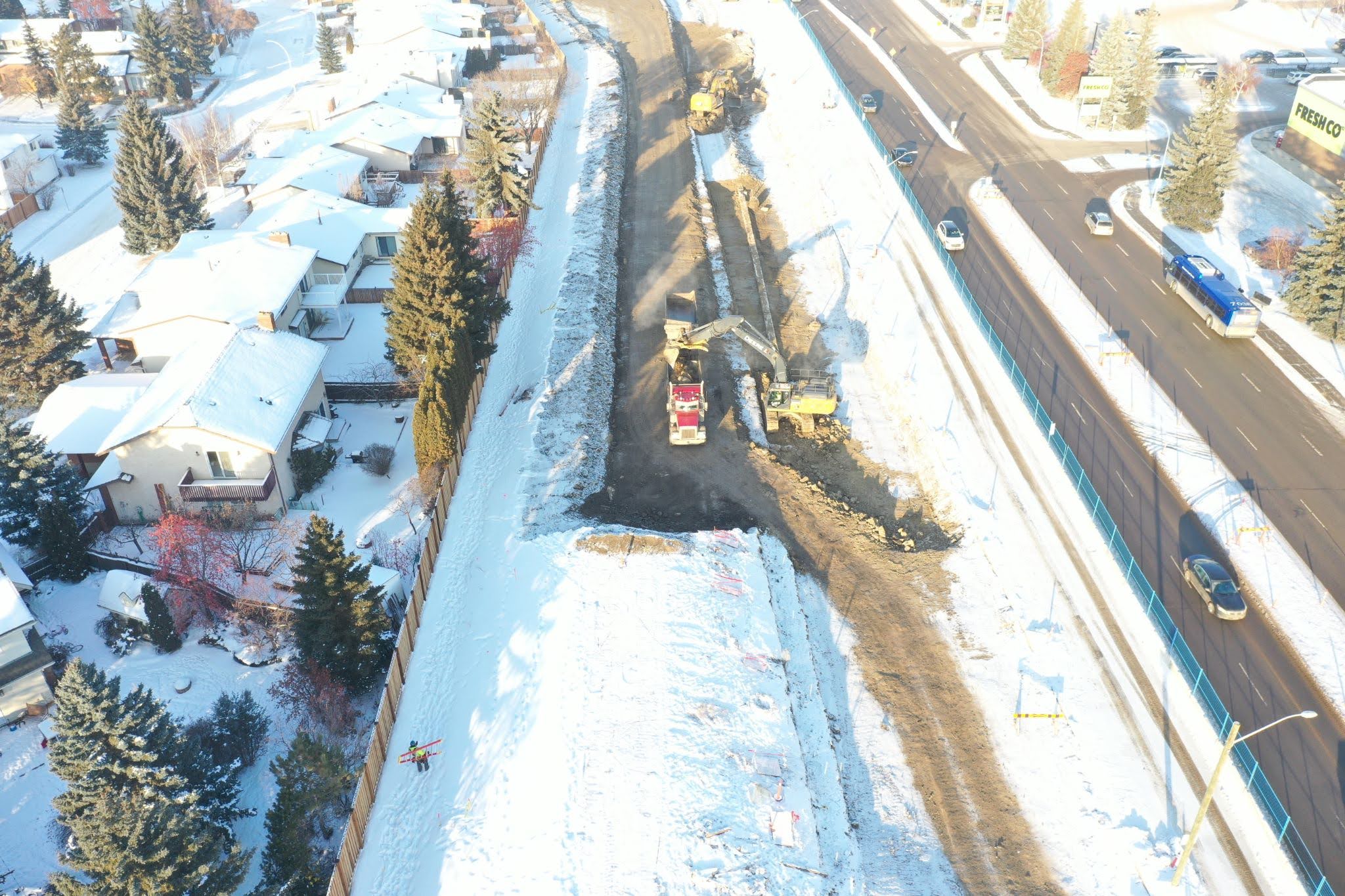

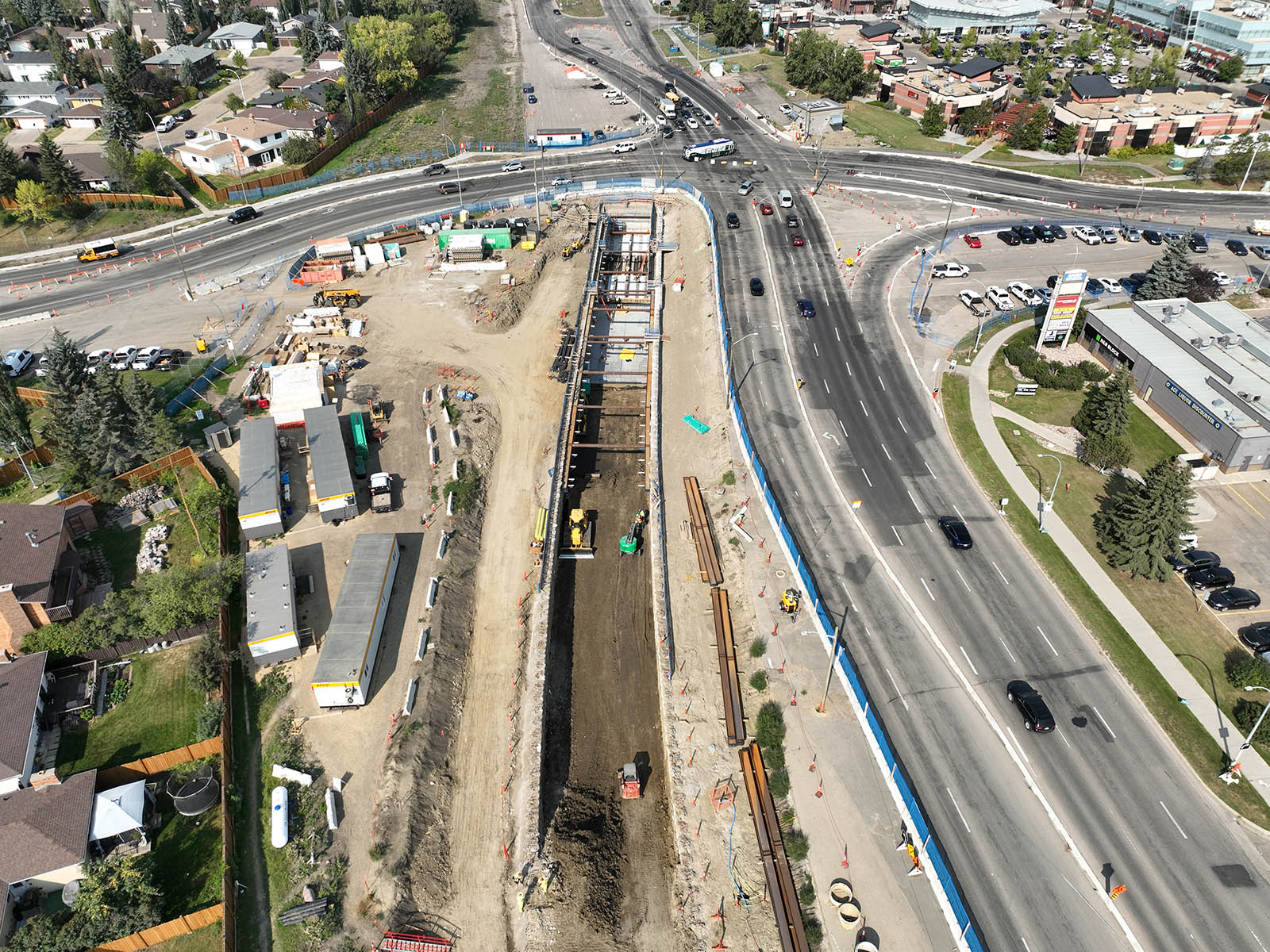

- An underpass at 23 Avenue
- Crossing arms, gates and bells at intersections

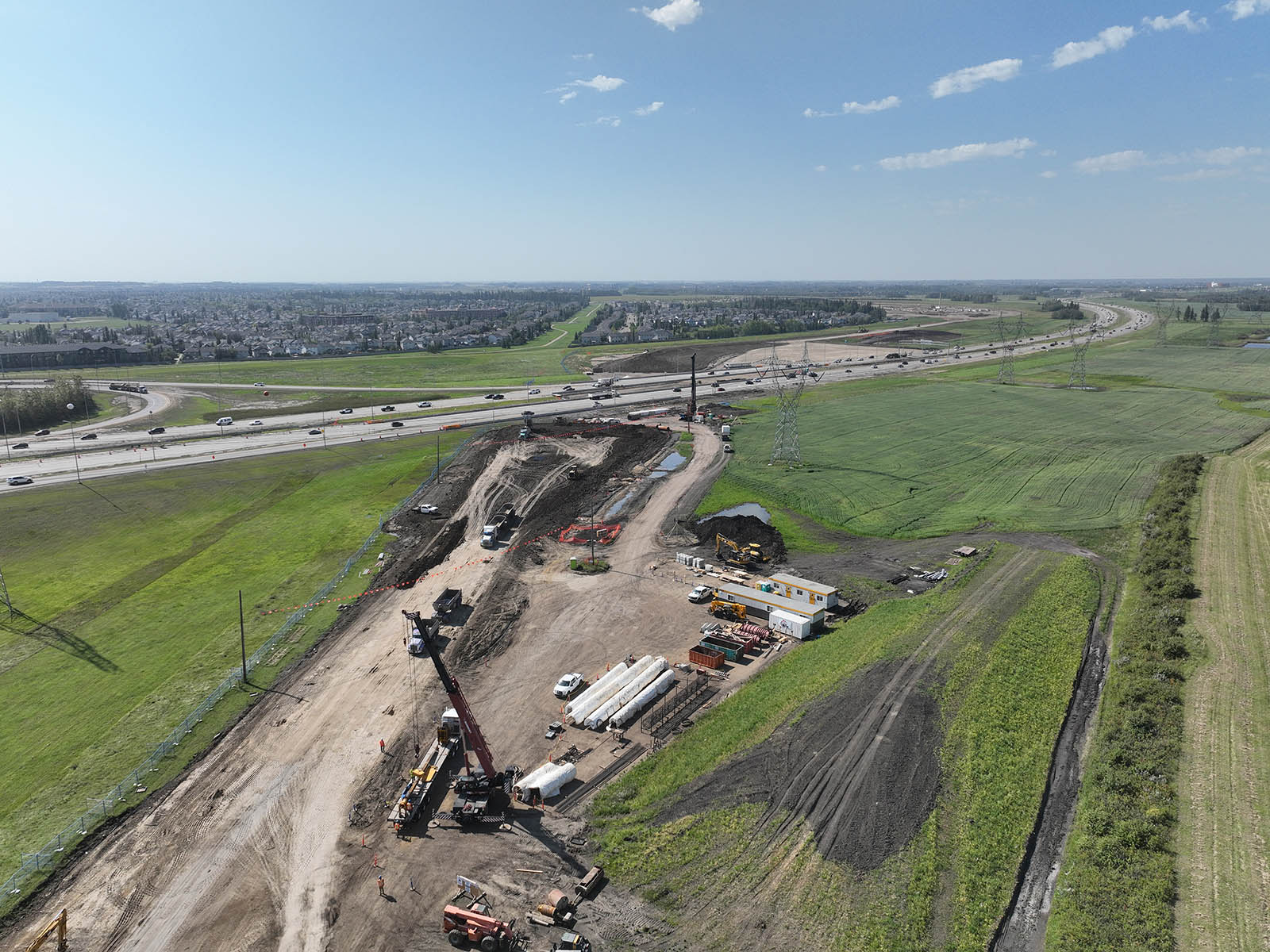

- Bridges crossing Blackmud Creek and Anthony Henday Drive

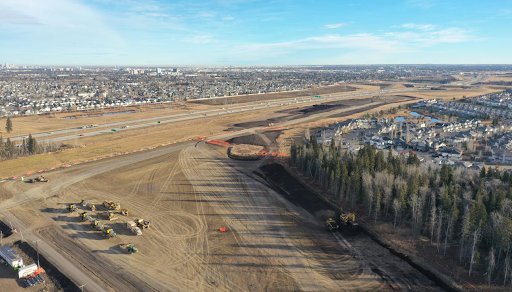

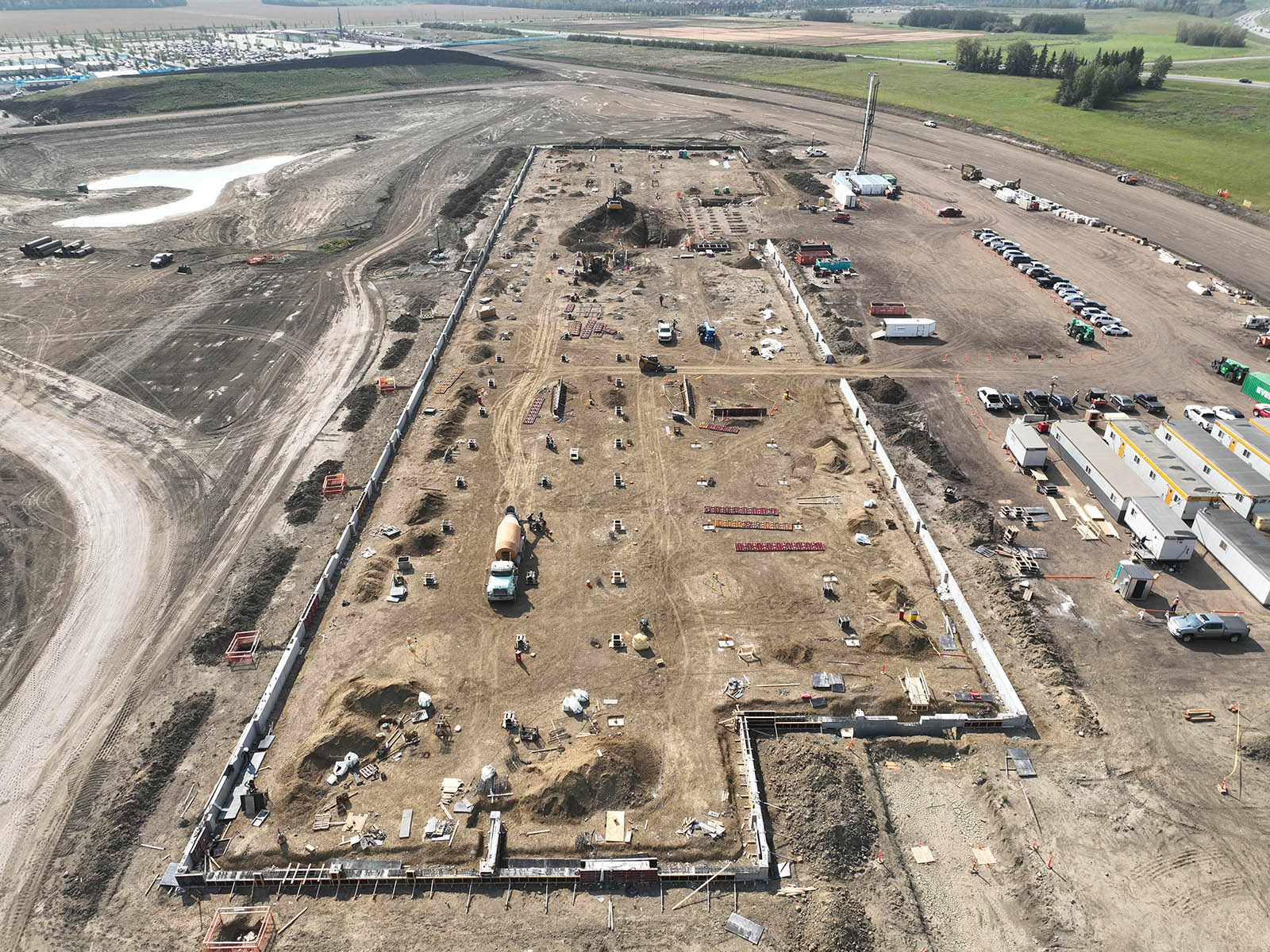

- Llew Lawrence Operations and Maintenance Facility south of Anthony Henday Drive

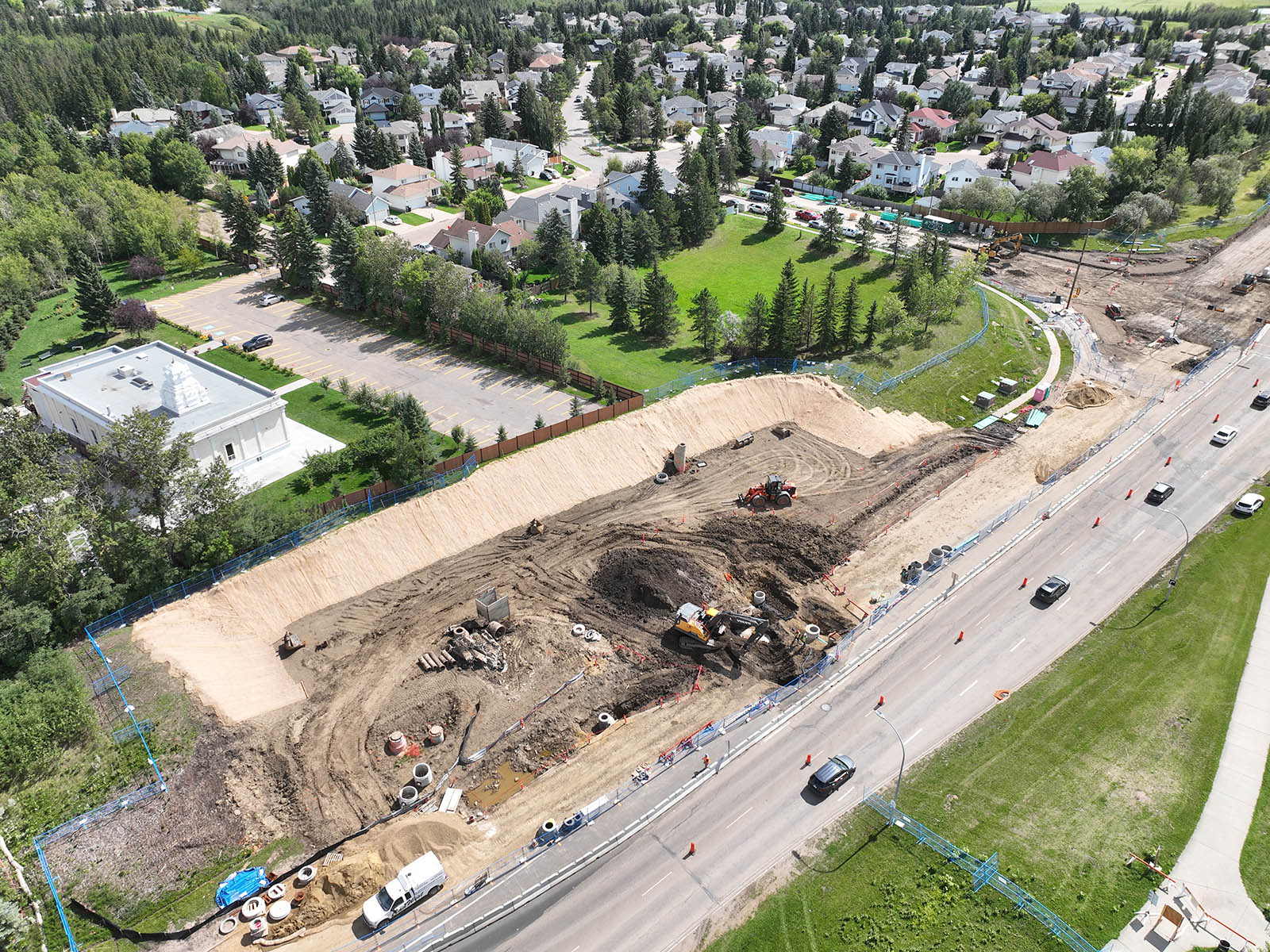

- Twin Brooks neighbourhood LRT station (smaller in size compared to a multi-modal transit station like Century Park)
- Heritage Valley North LRT station (connecting to the Heritage Valley Transit Centre and Park & Ride just north of Ellerslie Road)
Century Park to Heritage Valley
Map Legend
![]() | Design/Build Phase |
|---|---|
![]() | Bridge |
![]() | Park & Ride |
![]() | Stops or Stations |
| Operations and Maintenance Facility |
When to Contact the City of Edmonton
Careful consideration went into planning the Capital Line South Extension. But it’s only one part of a larger vision. The City of Edmonton handles feedback regarding:
- Project history and decisions
- Route selection
- City Council decisions about the line
- The City’s vision for LRT
- Neighbourhood Impact
Contact the City at lrtprojects@edmonton.ca, or call 780-496-4874 (voicemail)
When to Contact Capital Line Design-Build Ltd.
Capital Line Design-Build Ltd., a Ledcor Group of Companies, is the contractor retained by the City to perform the construction of the Capital Line South Extension. Ledcor handles inquiries regarding:
- Construction-related information
- General cleanliness of sites
- Repairs of damages related to construction activity
- Ongoing construction and site-required activities
Contact Ledcor at capitallinesouth@ledcor.com or call the public inquiry line at 780-540-7013 (voicemail).
If you believe you have a claim for damages, please contact CapitalLineSouth.Incidents@ledcor.com.
Contact Us
LRT Projects Information Centre
General project inquiries
Email lrtprojects@edmonton.ca
Phone 780-496-4874 (voicemail) or 311
Ledcor Group of Companies
(construction-specific inquiries)
Email capitallinesouth@ledcor.com
Phone 780-540-7013
